City Hall Project 2026

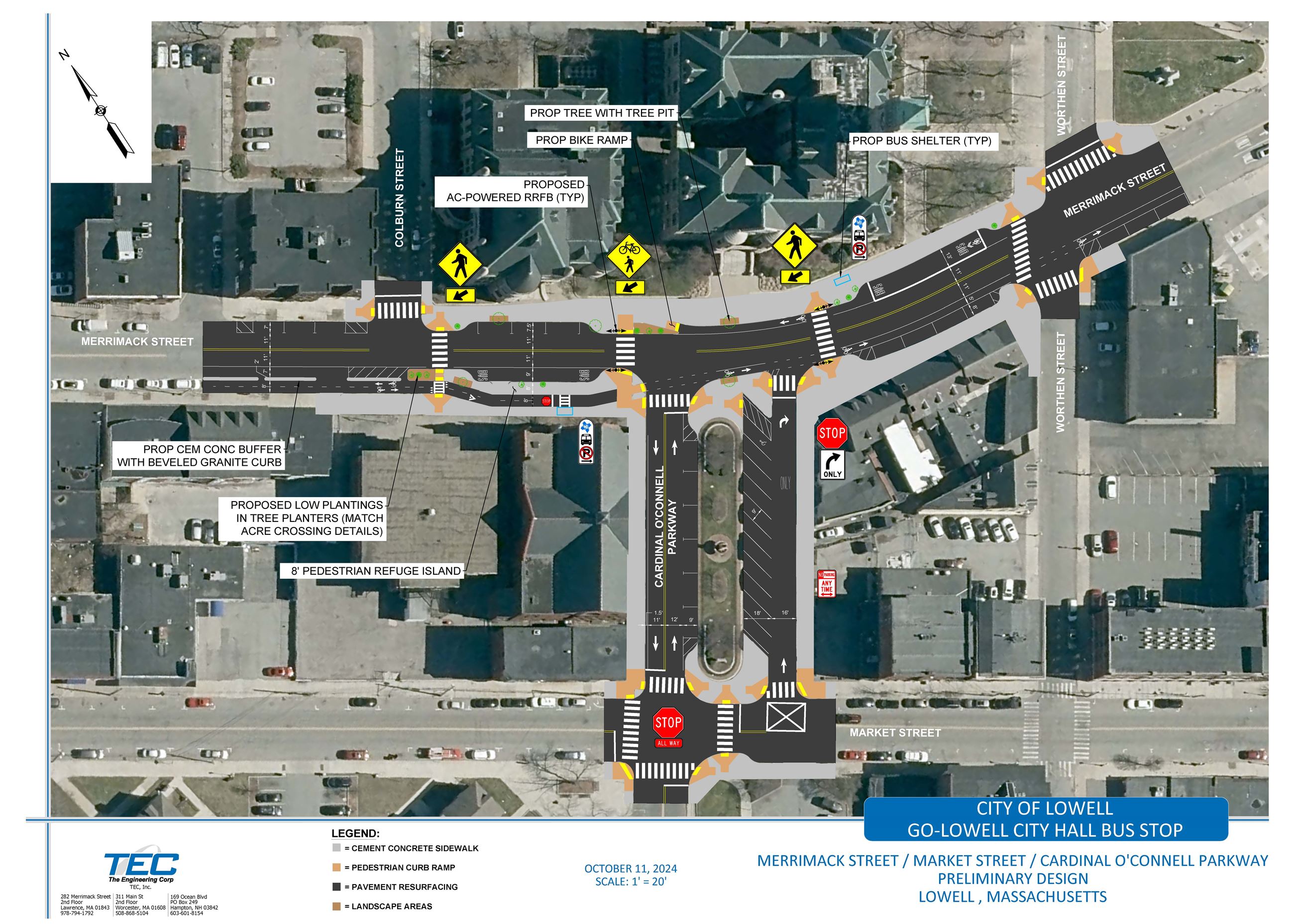

๐ GO LOWELL – CONSTRUCTION SCHEDULE LOOK-AHEAD
Project Area: Merrimack Street (City Hall area) & Cardinal O’Connell Parkway
Construction Start: March 9, 2026
Estimated Completion: Late October 2026
๐ข MARCH 2026
March 9–24: Construction Mobilization
Residents will see:
Construction vehicles and equipment arriving
Digital message boards installed
Advance warning signs placed
Survey crews marking sidewalks and roadway
Initial sawcutting of pavement (cutting pavement edges before removal)
Installation of erosion control (storm drain protection)
Tree protection installed around trees that will remain
๐ก Expect temporary parking restrictions and some sidewalk narrowing.
March 20 (Approx.): Tree Removal – Merrimack Street
Tree removal scheduled for one day
Work limited to specific trees approved through the hearing process
Likely short-term lane impacts during active removal
๐กNoise from chainsaws and equipment should be expected that day.
March 23–24: Removal of Site Features
Temporary removal of:
Benches
Trash cans
Parking meters
These items will be reinstalled later in the project.
๐ต LATE MARCH – APRIL 2026
PHASE 1: DRAINAGE & UTILITY WORK
March 25 – April 21
This phase focuses on underground infrastructure improvements before sidewalks are rebuilt.
๐ Merrimack Street (Station 100+50 to 103+20)
March 25 – April 7
Work includes:
Installing new gutter inlets
Replacing catch basins
Connecting new drainage pipes
Removing and replacing older drainage structures
๐ก๐งResident Impact:
Daytime lane shifts
Steel road plates covering trenches at night
Possible short-term driveway access interruptions
Construction noise from excavation
๐ Cardinal O’Connell Parkway @ Market / Dummer
April 8 – April 10
Work includes:
Installing drainage inlet
Rebuilding a catch basin
Modifying existing manholes
๐งResident Impact:
This will likely create short-term lane narrowing at the intersection.
๐ Merrimack Street (Station 103+50 to 106+50)
April 13 – April 21
Work includes:
Installing additional drainage pipe
Replacing light poles with new foundations
Electrical conduit installation
๐ก๐งResident Impact:
Temporary sidewalk closures
Brief power interruptions possible during pole swaps
Lane restrictions during excavation
๐ก LATE APRIL – EARLY OCTOBER 2026
PHASE 2: SIDEWALK & CURB RECONSTRUCTION
This is the longest and most visible portion of the project.
Work happens in segments so the entire street is not torn up at once.
PHASE 2A
๐Merrimack Street (Right Side)
April 22 – May 12
Work includes:
Full sidewalk demolition
New curbs installed
New ADA ramps (#4 & #6)
New concrete driveways
Installation of raised bike lane (May 12)
Solar-powered pedestrian crossing foundation installed
๐ก๐งResident Impact:
Pedestrian detours
Businesses remain open but access paths may shift
Driveways temporarily inaccessible while concrete cures
PHASE 2B
๐Cardinal O’Connell Parkway / Market / Dummer
May 13 – June 2
Sidewalk replacement
New curbing
Multiple ADA ramp installations (#7–#14)
Driveway reconstruction
Intersection access maintained but narrowed.
PHASE 2C
๐Cardinal O’Connell Parkway (400+00 to 402+30)
June 3 – June 24
Sidewalk demolition and replacement
Hydrant adjustment
New ADA ramps
Driveway reconstruction
๐ก๐งResident Impact:
Expect short-term driveway closures (24–48 hrs during concrete cure).
PHASE 2D
๐Merrimack Street (Right Side continuation)
June 25 – July 16
Additional sidewalk replacement
Curb work
Solar RRFB crossing foundation installed
ADA ramps (#11, #16, #17, #21, #23)
๐ก๐งResident Impact:
Pedestrian detours
Businesses remain open but access paths may shift
Driveways temporarily inaccessible while concrete cures
๐ถ JULY 22–31 – NO CONSTRUCTION
Project pauses during Lowell Folk Festival
PHASE 2E
๐Merrimack Street – City Hall Side (100+50 to 103+50)
July 17 – August 21
Sidewalk demolition
Curb reconstruction
Flashing beacon relocated near Coburn Street
ADA ramps (#1, #2, #5)
Solar pedestrian crossing foundation
This shifts work to the opposite side of the street.
๐ก๐งResident Impact:
Pedestrian detours
Businesses remain open but access paths may shift
Driveways temporarily inaccessible while concrete cures
PHASE 2F
๐Merrimack Street – City Hall Side (103+50 to 105+50)
August 24 – September 14
Sidewalk replacement
ADA ramp #20
Driveway reconstruction
Solar crossing foundation
๐ก๐งResident Impact:
Pedestrian detours
Businesses remain open but access paths may shift
Driveways temporarily inaccessible while concrete cures
PHASE 2G
๐Merrimack Street – City Hall Side (105+50 to 107+00)
September 15 – October 5
Final sidewalk reconstruction segment
ADA ramps (#22, #24, #25)
By early October, sidewalk reconstruction is complete.
๐ด OCTOBER 2026 – FINAL FINISHES
Early October (Night Work)
Roadway milling (Oct 6–7)
Utility casting adjustments
Final asphalt paving (Oct 14–20)
Permanent pavement striping (Oct 21–22)
๐ Night work reduces daytime traffic disruption.
Mid October – Streetscape Installation
Landscaping (trees, shrubs, mulch)
Benches & trash receptacles reinstalled
Two new bus shelters installed
Solar pedestrian flashing beacons activated
New traffic signs installed
Late October
Punch list corrections
Final inspections
Project closeout
Estimated substantial completion: Late October 2026
